DuPont shift work schedule: How it works, pros and cons

The DuPont shift work schedule is a 12-hour, four-crew rotation that repeats every 28 days and keeps an operation staffed 24/7. Each crew works 14 shifts per cycle and averages 42 hours a week. The fact to plan around is how unevenly those hours fall: a 72-hour peak week, then seven straight days off.

E. I. du Pont de Nemours and Company (DuPont), the chemical company, is credited with developing this pattern for plants that never stop. Healthcare teams now adapt it for round-the-clock patient care. There, a misjudged peak week shows up as overtime bills and empty appointment slots. So learn the cycle, its costs, and the rollout before you commit.

Key takeaways

Key takeaways

The DuPont shift work schedule uses four crews on 12-hour shifts across a 28-day rotating cycle to deliver 24/7 coverage.

Each crew averages 42 hours per week, but Week 2 reaches 72 hours, and three of the four weeks pass the 40-hour overtime line.

Every crew gets a full seven-day rest block every four weeks, which helps work-life balance but concentrates fatigue in the 72-hour peak week.

Common modifications include 8/12-hour hybrids and fixed day and night crews for settings where full rotation is hard to run.

Pabau, the practice management platform we build, has scheduling and timesheet tools that help you manage staff rotas and availability.

Found our content helpful?

The DuPont shift work schedule covers 24/7 with four crews

The DuPont shift work schedule is a rotating 12-hour pattern that uses four crews to cover every hour of every day. It repeats on a 28-day cycle. Day shifts typically run from 7 am to 7 pm, and night shifts from 7 pm to 7 am.

The four-crew structure is what makes round-the-clock coverage work. On any given day, one crew works days, one works nights, and two are off. For practice managers, that means a predictable 28-day template that repeats unchanged.

The core structural facts of the standard pattern:

  • Shift length: 12 hours (day or night)
  • Crews required: four
  • Cycle length: 28 days
  • Shifts per crew per cycle: 14, or 168 hours
  • Average weekly hours: 42 (across the full cycle)
  • Peak weekly hours: 72 (Week 2, once per cycle)
  • Longest run of nights: four (Week 1)
  • Full rest block: seven consecutive days off every four weeks

A DuPont schedule example: One crew’s 28-day cycle

The 28-day cycle runs each crew through blocks of nights, days, and rest. Every crew follows the same sequence, offset by one week. The table below shows Crew A’s pattern across the full cycle.

WeekPatternShifts workedDays offHours worked
Week 14 nights on, then 3 days off4348
Week 23 days on, 1 day off, then 3 nights on6172
Week 33 days off, then 4 days on4348
Week 47 days off070
Total28-day cycle1414168

Week 2 is the pattern’s hardest stretch. Crew A works three day shifts, takes one day off, then works three night shifts. That is six 12-hour shifts and 72 hours in seven days, plus a switch from days to nights with a single rest day between them.

Week 2 is also where overtime exposure peaks for employers of non-exempt staff. The seven-day rest block in Week 4 is the design’s counterbalance, giving workers a full week to recover before the cycle restarts.

Each of the four crews follows this same sequence, staggered by one week. While Crew A rests in Week 4, Crews B, C, and D are in Weeks 3, 2, and 1. The grid below shows how that stagger keeps one crew on days and one on nights, every day of the cycle.

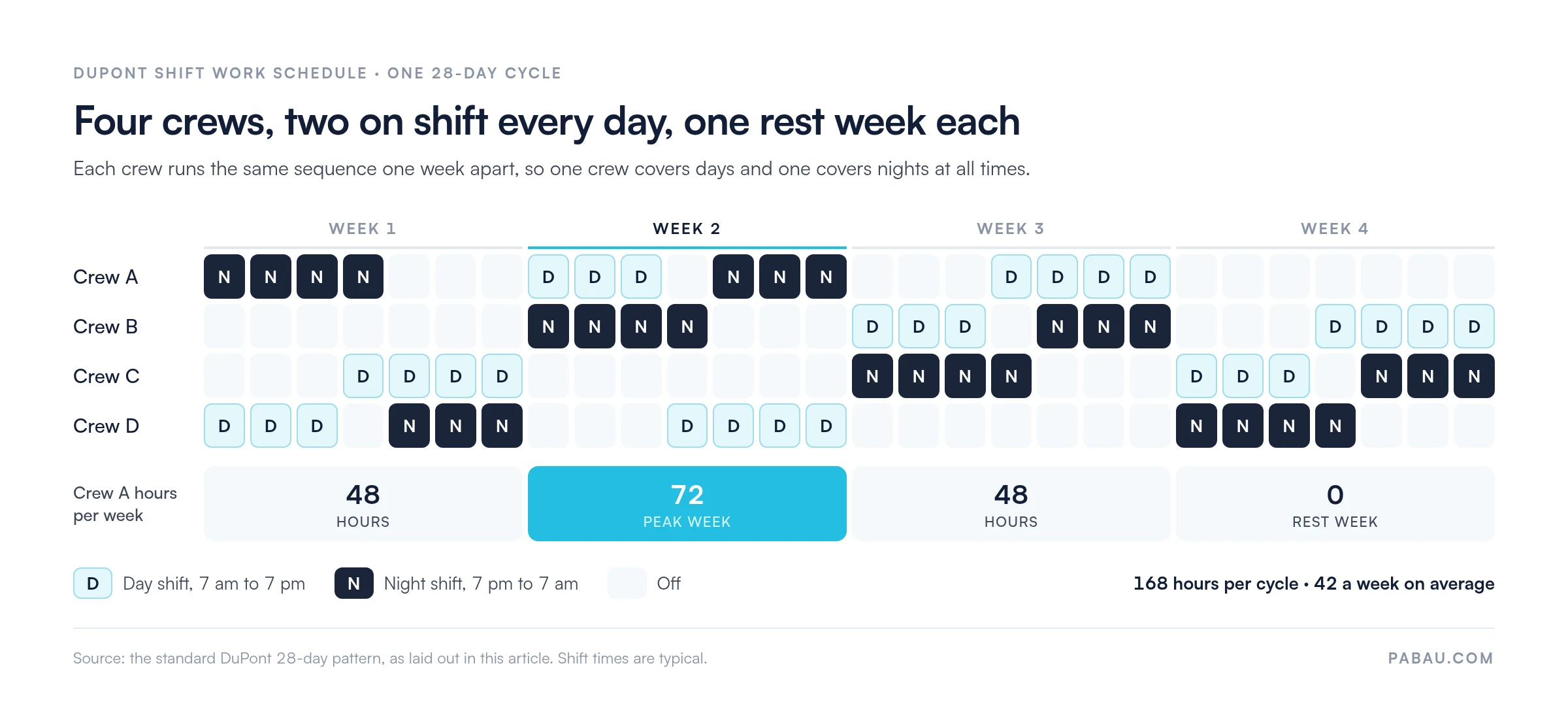

Grid of the DuPont 28-day cycle for crews A to D
Read down any day and you will find exactly one day crew and one night crew. Pattern taken from the standard DuPont cycle described above.

Prefer a ready-made layout? Our rotating 12-hour shift schedule template sets out the same day, night, and rest blocks for each crew.

Overtime on the DuPont schedule adds up week by week

Across the full 28-day cycle, each crew works 14 shifts of 12 hours, totaling 168 hours. Divided by four weeks, that averages 42 hours per week. On paper, that looks manageable. The catch is how the hours are distributed.

Under the Fair Labor Standards Act (FLSA), overtime is calculated week by week, not as a cycle average. Three of the four weeks cross the 40-hour line. Weeks 1 and 3 each create 8 overtime hours, and the 72-hour Week 2 creates 32. That adds up to 48 overtime hours per cycle for every non-exempt employee on the rota.

Here is one cycle’s pay for a non-exempt employee on a $20 hourly base rate, with overtime at 1.5x, or $30 an hour:

WeekHours workedRegular hoursOvertime hoursEst. gross pay
Week 148408$1,040
Week 2724032$1,760
Week 348408$1,040
Week 4000$0
Cycle total16812048$3,840

The overtime premium, the extra half-time on top of straight pay, is $10 for each overtime hour. Week 2 alone carries 32 × $10, or $320, above straight-time pay. Across a full cycle the premium is $480. Over 13 cycles a year, that reaches 624 overtime hours and $6,240 in premium per non-exempt employee.

That is a meaningful budget line for any practice running the pattern on clinical or support staff. Run it past your HR team and employment counsel first. California adds another layer. Employers there must follow the state’s alternative workweek election rules, or 12-hour shifts trigger daily overtime under the California Labor Code.

DuPont schedule pros and cons: A rest week paid for with a 72-hour week

The DuPont shift work schedule has a mixed record across the industries that use it. Here is how it looks from each side of the rota.

Employer advantages

  • Full 24/7 coverage with four crews: every shift is staffed by design, without last-minute overtime calls to patch a two- or three-crew model.
  • Fewer handovers per week: 12-hour shifts mean fewer shift changes than an 8-hour three-shift pattern, reducing communication errors at the transition point.
  • Predictable rota: the 28-day cycle repeats unchanged, so it can be published months ahead and run from software built for practices.
  • Staff retention lever: some employers use the full week off every four weeks to stand out in competitive hiring markets.

Employee advantages

  • Seven consecutive days off every four weeks allows for recovery, travel, and personal projects that shorter rest periods cannot.
  • Working 14 shifts in 28 days leaves 14 full days off, more than a five-day-a-week schedule gives, even with 12-hour shifts.
  • The overtime premium in Weeks 1, 2, and 3 can lift take-home pay for employees who value higher earnings.

Disadvantages to weigh

  • Week 2 fatigue: six 12-hour shifts in seven days, with a switch from days to nights after one rest day, is the cycle’s hardest stretch.
  • Overtime costs: three of every four weeks exceed 40 hours, creating 48 overtime hours per cycle for each non-exempt employee.
  • Night-shift health risks: regular rotation onto nights brings circadian disruption, which research links to long-term health risks (covered in the next section).
  • Complexity for smaller teams: the pattern requires exactly four crews of sufficient size. A practice that cannot field four full crews cannot run the standard pattern without modification.

Is the DuPont schedule bad for your health?

It can be, because it carries the health risks of any rotating night work. Those include circadian disruption, poorer sleep, and higher cardiovascular and metabolic risk over time. Its own pressure points are the four-night run in Week 1 and the quick switch from days to nights in Week 2.

The direction of the evidence is clear. NIOSH training on shift work and long hours links night and rotating schedules with sleep disorders, cardiovascular disease, metabolic problems, and gastrointestinal complaints.

Those associations come from long-term exposure. A worker doing one DuPont rotation is not in the same risk category as someone who has worked nights for fifteen years.

The pattern’s nights come in short blocks. The longest run is four nights, in Week 1, and Week 2 adds three more. Workers stay on one circadian phase for a few nights at a time rather than flipping every other day. Three rest days follow each night block.

The harder part is the Week 2 turnaround. Moving from three day shifts to three night shifts with one rest day between them gives the body little time to adjust. The seven-day rest block then offers more recovery time than most rotating schedules. That does not remove the risk, but it puts it in context.

Practical ways to soften the risk for night-shift staff:

  • Protect the rest day in Week 2 so staff are not called in between the day block and the night block
  • Ensure adequate blackout conditions and rest facilities for staff coming off night blocks
  • Give staff a night-shift sleep schedule to follow around each night block
  • Monitor absence and performance during and after Week 2 as early signals of fatigue
  • Encourage staff to raise shift-related health concerns with their own practitioners, since tackling burnout in healthcare early prevents longer-term attrition

Modified DuPont schedules ease the peak week

A modified DuPont schedule adjusts the standard pattern to ease the 72-hour peak week or to suit settings where 12-hour blocks are impractical. Some versions also answer local labor rules.

Two common modifications are compared below.

VariationChange from standardWeekly hoursBest for
8/12 hybridReplaces some 12-hour blocks with 8-hour shifts and keeps the four-crew structure.Varies by design (below 42)Practices with a mid-day peak in demand that 12-hour blocks don’t match
Fixed nights variantTwo crews stay on nights and two stay on days, with no rotation.Depends on the fixed pattern (about 42 on a 4-crew 12-hour rota)Staff who choose permanent nights, which cuts forced circadian switching

The fixed-nights variant is worth a look in a practice setting. Some research suggests staff who choose permanent nights tolerate them better, though evidence on absence is mixed. If some of your practitioners prefer overnight or late-hour work, a permanent night crew may suit them better than forcing rotation across all four.

Which industries use the DuPont shift work schedule?

The DuPont shift work schedule suits any operation that cannot stop, where an uncovered shift costs more than the overtime premium of running four crews. Demand for that kind of coverage is broad.

According to Bureau of Labor Statistics data from 2017–18, 16% of US wage and salary workers usually worked something other than a regular daytime schedule. The DuPont pattern turns up most often in these sectors:

  • Manufacturing and chemical production: the original context for the DuPont pattern, where process lines run continuously and shutdowns are expensive.
  • Oil, gas, and utilities: refineries, power plants, and water treatment facilities need staff on site at every hour, every day.
  • Emergency services: fire, police, and emergency dispatch operations use the pattern or close variations to maintain response capability around the clock.
  • Healthcare and hospitals: inpatient wards, emergency departments, and intensive care units require continuous nursing and clinical coverage, making the four-crew 12-hour structure a natural fit.
  • Security and facilities management: 24/7 site coverage requirements align directly with the DuPont crew structure.

Healthcare use of the DuPont shift work schedule reaches beyond hospitals. Urgent care centers, residential care facilities, and multi-practitioner practices with extended hours also evaluate it as patient demand moves toward evenings and weekends.

If the operation runs fewer than 18 hours a day, four crews and 12-hour blocks may not justify the overhead.

DuPont vs 2-2-3: Longer rest or a lighter peak week

The DuPont pattern is one of several 12-hour four-crew systems. Choosing between them means trading off rest-block length, peak weekly hours, and cycle complexity.

ScheduleCrewsAvg. weekly hoursMax single-week hoursLongest rest block
DuPont442727 days
2-2-3 (Pitman/Panama)442483 days

The 2-2-3 rotation goes by both the Pitman and Panama names, and it alternates 36-hour and 48-hour weeks. That keeps its peak week 24 hours lighter than DuPont’s, but its rest blocks top out at three days. DuPont’s distinguishing feature is the seven-day rest block, a full week off in every cycle.

If the full rest week matters most as a retention and recovery tool, DuPont is the pattern that delivers it. If lowering peak weekly hours matters more, especially for fatigue-sensitive clinical roles, 2-2-3 is the better choice. Our Panama shift schedule template lays out that pattern if you want to compare the two.

How a DuPont rota runs day to day in a practice

Running the DuPont shift work schedule in a practice is harder than in a factory, because patient bookings have to follow the staff rotation. A practitioner off for a full week is easy to handle if her appointments are covered. It becomes a problem when her calendar sits empty and patients are turned away.

Take Crew A’s Week 2, starting on a Monday. Monday to Wednesday are day shifts, each opening at 7 am with a handover from Crew B, who are on nights that week. Thursday is the single rest day. Friday evening starts a three-night block that runs through Sunday.

From Friday on, Crew A can’t take daytime appointments, so the front desk needs to see that change in the booking calendar. Trouble starts when the rota lives in a spreadsheet and the appointment book lives somewhere else. Bookings land with practitioners who are asleep after a night shift.

Before you roll it out: A DuPont rota checklist

Work through these six checks before the first cycle starts. Each one is cheaper to fix on paper than mid-rotation.

  1. Audit your operating hours. Confirm the practice runs, or plans to run, enough hours to justify four crews and 12-hour blocks. That overhead only pays off when you need continuous coverage.
  2. Define each crew. Every crew needs enough practitioners and support staff to run the service on its own. A practice that relies on one consultant for a key specialty can’t send them on a seven-day rest block every month.
  3. Budget the overtime. Non-exempt staff hit overtime in three of the four weeks, most heavily in Week 2. In California or another state with daily overtime rules, talk to HR counsel before the rota goes live.
  4. Build the rota template once. The 28-day cycle repeats without variation, so set it up once in your scheduling software and roll it forward. Rebuilding it by hand each month invites errors.
  5. Link bookings to the rota. Your booking system should show which practitioners are on shift each day. For scheduling patients effectively on a rotating rota, availability has to move with the crews week by week.
  6. Plan how you will watch Week 2. The peak week is where sick calls and fatigue-related incidents are most likely. Team management tools that track attendance against the cycle show early which crews are struggling.

Common DuPont rota mistakes and how to avoid them

These are the slip-ups that tend to undo a DuPont rollout in its first few months.

  • Averaging overtime across the cycle. The FLSA counts each workweek on its own, so a 42-hour average still produces 48 overtime hours per cycle. Pay and budget week by week.
  • Calling staff in on the Week 2 rest day. That single day is the only break between three days and three nights. Treat it as protected, even when cover is short.
  • Letting a rest block land on a busy period. The seven-day rest block falls on different dates for each crew through the year. Map the full 52-week calendar against your known high-demand dates before you share the rota.
  • Fixing clashes after publication. If a rest block falls across a peak week, adjust the crew offset or agree cover in advance. A clash found later turns into last-minute overtime.
  • Building a crew around one person. If one practitioner holds a skill nobody else in the crew has, their rest week takes that service offline.
  • Taking sick-call cover from the same crew every time. Cover comes from the two crews off that day, so spread it between them. Otherwise one crew loses its rest days week after week.

Managing a DuPont rota in Pabau

Many practices plan a rotating rota in a spreadsheet and keep the appointment book in a separate system. When the two drift apart, patients get booked with practitioners who are on a rest week, and the front desk has to rebook them.

In Pabau, the practice management software we build, staff rotas and availability sit in the same system as your appointment calendar and patient records. Timesheets record the hours each team member works, so weekly totals are on hand when you review overtime.

Your front desk books patients with the practitioners on shift that day. Managers can see each crew’s week in one place.

Manage staff rotas alongside your appointment book

Pabau’s scheduling and timesheet tools help you manage staff rotas and availability in the same platform you use for appointments and patient records.

Pabau practice scheduling dashboard

Conclusion

The DuPont schedule earns its place when you need 24/7 coverage and can field four full crews. Staff value the rest week, and it helps with both recruiting and recovery. You pay for it with a 72-hour peak week and 48 overtime hours per cycle for every non-exempt employee.

So settle two numbers first: crew headcount and the overtime budget. If both hold up, the pattern pays back with a rota you build once and reuse all year. If either looks shaky, a 2-2-3 rotation or a fixed day and night split is the safer choice.

Book a demo to see how Pabau keeps your DuPont rota and your appointment book in step.

Continue your research

Continue your research

Need a ready-made layout for a 12-hour crew rota? Rotating 12-hour shift schedule is a free template for planning day, night, and rest blocks across your crews.

Working out how many staff each crew needs? Healthcare workforce planning shows how to forecast the headcount a four-crew rota depends on.

Checking weekly hours against the 40-hour line? Free timesheet template gives you a weekly log for recording the hours each team member works.

Want to reduce no-shows across rotating shift coverage? How to improve patient no-show rate covers the automated reminder and confirmation workflows that keep attendance high when practitioner availability changes weekly.

Managing staff across more than one practice location? Multi-location scheduling software explains how to synchronize rotas and room availability across locations without duplicating administrative effort.

Frequently asked questions

How many employees do you need for a DuPont schedule?

You need at least four people for every post you want covered around the clock, one in each crew. Most employers add some slack on top. Without it, every sick day or vacation pulls someone from an off crew into overtime.

How many hours a year does a DuPont schedule work out to?

About 2,184 hours, from 168 hours per 28-day cycle across 13 cycles. A standard 40-hour week over 52 weeks comes to 2,080 hours. So DuPont staff work roughly 104 more hours a year.

Can you get two weeks off on a DuPont schedule?

Yes, with four shifts of leave. Book the four day shifts that close Week 3 as vacation. They sit between three rest days and the seven-day rest block, which gives 14 days off in a row.

Who covers a sick call on a DuPont schedule?

Cover usually comes from one of the two crews that are off that day, which means overtime. Avoid pulling anyone out of their seven-day rest block where you can. Track who covers, so the extra shifts don’t keep landing on the same people.

Is the DuPont schedule the same as the Pitman schedule?

No. Both use four crews on 12-hour shifts and average 42 hours a week. The Pitman, or 2-2-3, pattern never goes above 48 hours in a week, but it never gives more than three days off in a row. DuPont peaks at 72 hours and adds a full rest week.
